Quick start
The checker is embedded on this first screen. Start with the primary CTA, then review evidence and risk layers below.
This single canonical URL handles both intents: immediate tool use and deeper decision confidence. Searches for “aluminium scaffold planks”, “aluminium scaffolding planks”, “aluminium scaffolding plank”, “aluminium scaffold planks for sale”, “aluminium scaffold platform”, “aluminium scaffold plank”, “aluminium scaffolding board/boards”, “aluminium scaffold board/boards”, and “aluminium scaffold plank dimensions” are handled on this same page. Run the checker first, then use the report sections to validate load, width, span, movement, and compliance boundaries before issuing RFQ.
Published Apr 4, 2026. Updated Apr 27, 2026. Page URL: https://aluminiumscaffoldtower.com/aluminium-scaffold-platforms
OSHA design factor
>= 4x max intended load
29 CFR 1926.451(a)(1) requires scaffold and component capacity well above planned load, so duty labels alone are insufficient.
AU duty + concentrated loads
225/450/675 kg + 120/150/200 kg
Safe Work Australia adds both distributed and concentrated-load references, which improves first-pass RFQ classification.
Platform geometry floor
450 mm / 18 in + tight plank gaps
OSHA requires at least 18 in width for most scaffolds and <=1 in plank gaps; AU guidance references >=450 mm and <=10 mm plank gaps.
Use this CTA after running the checker. The draft keeps duty class, width, span, and boundary language in one supplier thread.
Section navigation
Alias note
This page explicitly answers “aluminium scaffold planks”, “aluminium scaffolding planks”, “aluminium scaffolding plank”, “aluminium scaffold planks for sale”, “aluminium scaffold platform”, “aluminium scaffold plank” (singular), “aluminium scaffolding board/boards”, “aluminium scaffold board/boards”, “alloy scaffold planks”, and “aluminium scaffold plank dimensions” on one canonical URL. No separate alias page is created.
Report summary
These cards capture the decision-critical findings from current public evidence. Each conclusion links to the source and states what is known versus where manual confirmation is still required.
Best fit for this checker
Use with caution
Not suitable as final authority
Market and enforcement signals
This table turns time-stamped regulatory and incident updates into concrete procurement decisions. Use it to decide whether speed gains are worth the compliance and rework risk in your route.
Swipe horizontally to compare signal timing, decision tradeoffs, and downside risk.
| Signal lane | Latest verified signal | Tradeoff if you apply it | Risk if ignored | Source |
|---|---|---|---|---|
| US enforcement ranking (FY 2025) | OSHA lists scaffolding standard 1926.451 as #6 in the federal Top 10 list (page updated 2026-04-15). | Boundary evidence increases first-pass effort but lowers citation and rework exposure in regulated workflows. | Fast quote cycles can convert into stop-work, corrective action, and contract friction when basic boundary controls fail. | OSHA Top 10 cited standards (FY 2025) |
| US penalty schedule (29 CFR 1903.15) | For penalties proposed after 2025-01-15, serious/other-serious max is $16,550 and willful/repeat max is $165,514 per violation. | Pre-quote compatibility and boundary checks take time, but they are cheaper than avoidable enforcement-cycle cost. | Price-first decisions without boundary evidence can carry disproportionate financial downside when violations are found. | OSHA 29 CFR 1903.15 civil penalty schedule |
| US citation policy pattern (memo 2024-04-17) | OSHA instance-by-instance policy appendix includes scaffold platform construction clause 1926.451(b)(1). | Clause-level clarity in RFQ language is slower up front but reduces ambiguity when procurement and compliance teams review the same job. | Generic RFQs can hide repeated clause-level defects, increasing citation severity and corrective-workload risk. | OSHA instance-by-instance citation policy memo (2024-04-17) |
| US construction-only enforcement table (NAICS 23) | OSHA cited-standards table shows 1926.451 with 2,159 citations and $7,818,667 current penalties, while scaffold training standard 1926.454 shows 251 citations and $549,791. | Adding explicit training, fall-protection, and access-lane evidence takes more upfront coordination but aligns with what construction inspections actually cite. | Teams can pass dimensions yet fail on training or operational controls, leading to avoidable citations and corrective workload. | OSHA NAICS 23 cited standards table (construction) |
| US active falls program scope (CPL 03-00-025) | OSHA Falls NEP directive (signed 2023-04-24; effective 2023-05-01) states construction inspections related to falls are conducted under this national program. | Building clause-level fall-control evidence into RFQs takes extra effort but improves inspection readiness before site activity scales. | Treating fall controls as post-award detail can expose teams to avoidable programmed-enforcement findings, not only incident-driven scrutiny. | OSHA CPL 03-00-025 National Emphasis Program - Falls |
| US incident baseline (BLS CFOI 2024) | BLS reports 5,070 total occupational fatalities in 2024, with 844 fatal falls/slips/trips; construction/extraction occupations report 370 fatal falls/slips/trips (release date 2026-02-19). | Conservative release gates may delay quotes, but they reduce decision error in high-consequence work-at-height contexts. | Treating uncertain support or overhead conditions as acceptable defaults keeps preventable high-severity risk in the workflow. | U.S. BLS Census of Fatal Occupational Injuries (2024, released 2026-02-19) |
| US non-fatal burden (BLS SOII annualized 2023-24) | BLS SOII Table 2 reports annualized 2023-24 private-industry falls/slips/trips values of 721,720 DART and 479,480 DAFW cases, with annualized rates 34.1 and 22.6 per 10,000 FTE workers (released 2026-01-22). | Adding pre-quote boundary checks can slow initial handoff but reduces lost-time and restricted-duty disruption risk after mobilization. | Teams may underestimate downstream productivity impact because a quote can look compliant while still carrying high non-fatal incident exposure. | U.S. BLS SOII Table 2 (2023-24 annualized, released 2026-01-22) |
| Australia planning gate (Safe Work Australia) | Current scaffolding hazard guidance flags SWMS trigger for >2 m fall-risk work and licensing trigger for scaffolding over 4 m, with licence classes split into basic/intermediate/advanced scaffolding. | Adding SWMS and licence checks early can slow handoff, but avoids late-stage compliance rejection. | Teams may issue quotes without legally required planning controls or with the wrong licence class, causing avoidable delays and escalation. | Safe Work Australia scaffolding hazard topic |
| NSW immediate enforcement signal (SafeWork NSW) | SafeWork NSW states that failing scaffold obligations can attract on-the-spot fines up to $900 for individuals and $4,500 for corporations. | Assigning inspection ownership and movement controls early adds small coordination overhead but reduces immediate enforcement-risk exposure. | “Price-first, role-later” quoting can create direct fine exposure and stop-work disruption before full project mobilization. | SafeWork NSW scaffolding obligations page |
| NSW regulator priority lens (Annual Regulatory Statement 2024/25) | SafeWork NSW 2024/25 statement highlights stronger penalty settings, targeted construction compliance including scaffold erection/use, and notes 17 construction-worker fatalities from falls from height in 2018-2022. | Adding explicit fall-prevention and scaffold-governance evidence early can reduce regulatory friction in NSW projects. | Commercially “fast” RFQs may still fail under targeted work-at-height enforcement where scaffold controls are weak or undocumented. | SafeWork NSW Annual Regulatory Statement 2024–25 |
| Australia claims structure (Safe Work workbook 2025) | For 2023-24p, Safe Work Australia reports 32,000 serious claims from falls/slips/trips, including 24.4% falls from height and 68.3% falls on the same level. | Screening for footing, movement, and access controls before purchase can reduce high-frequency non-fatal claim exposure. | Boundary-light procurement can shift hidden cost into injury claims, downtime, and corrective planning after delivery. | Safe Work Australia key WHS statistics workbook (2025, serious-claims split) |
| UK non-fatal profile (HSE 2024/25) | HSE reports falls from height as 8% of reported non-fatal injuries to employees, with annual rate 209 per 100,000 workers (2020/21 to 2024/25 average). | Explicit movement and footing controls in RFQ notes add up-front effort but reduce repeat corrective-work risk in tower workflows. | Projects can pass dimensional screening yet still absorb avoidable non-fatal injury disruption in execution. | HSE non-fatal injuries by accident type (Great Britain) |
| UK construction intensity (HSE construction 2025) | HSE reports construction fatal injury rate 1.92 per 100,000 workers (around 4.8x all-industry), around 50,000 non-fatal injuries per year (3-year average ending 2024/25), and falls from height at 53% of construction worker fatalities (5-year average). | More conservative route selection increases first-pass evidence workload but lowers mismatch risk between procurement assumptions and site controls. | Speed-focused quoting can miss sector-intensity risk, increasing likelihood of costly rework and compliance escalation. | HSE construction statistics in Great Britain (2025 release) |
| UK enforcement execution (HSE annual report 2024/25) | HSE annual report states 246 criminal prosecutions with 96% conviction, over GBP 33 million in fines, over 4,400 notices, and over 13,200 inspections. | Higher evidence quality in route and handover documentation takes time but materially improves defensibility during enforcement interactions. | Under-documented scaffold controls can become direct legal and financial outcomes, not only internal QA findings. | HSE Annual Report and Accounts 2024/25 |
| US federal penalty-update rule (2026-04-17 memo) | OMB M-26-11 directs agencies to issue no 2026 inflation adjustment and continue using 2025 civil-penalty levels due missing October 2025 CPI-U data. | A dated federal memo reference reduces penalty-baseline ambiguity in long-cycle bids and compliance budgeting. | Teams may over- or under-budget enforcement exposure if they assume a normal annual uplift without checking 2026 federal guidance. | OMB M-26-11 penalty inflation adjustment cancellation (2026-04-17) |
Method and evidence
The methodology is deterministic: language clustering, load band mapping, width/span checks, then environment/procurement boundaries.
Step 1: Normalize buyer language into one route
Treat “aluminium scaffold planks for sale”, “aluminium scaffold platform”, “alloy scaffold planks”, “aluminium scaffold planks”, “aluminium scaffolding plank”, “aluminium scaffolding board/boards”, “aluminium scaffold board/boards”, and “aluminium scaffold plank dimensions” as one purchase intent cluster and keep the user on this canonical page.
Step 2: Map requested load to dual evidence bands
Classify load against both distributed and concentrated public references (AU classes + OSHA load model) before discussing price.
Step 3: Apply geometry and deflection constraints
Check width, plank-gap, overhang, span/deflection, and energized-line/high-wind constraints. If any input cannot be evidenced, shift to controlled or manual route.
Step 4: Decide route by inspection and site obligations
Ground condition, movement restrictions, role ownership (competent vs qualified), inspection cadence, access/fall-protection gates, and documentation obligations decide whether release is RFQ-ready, controlled, or manual-review only.
Swipe horizontally to read the full evidence table on mobile.
| Source | Checked | How used in this page |
|---|---|---|
| OSHA 1926.451 general scaffold requirements | Apr 27, 2026 | Official U.S. regulation checked Apr 27, 2026. Used for 4x load-capacity rule, platform width/front-edge/overhang limits, plank-gap limits, energized-line clearances (3 ft / 10 ft / +0.4 in per 1 kV over 50 kV), high-wind prohibition controls, inspection cadence, 1/60 deflection cap, and dissimilar-metal intermixing boundary (competent-person galvanic-action determination before use). |
| OSHA 1926.450 scaffold definitions | Apr 27, 2026 | Official U.S. regulation checked Apr 27, 2026. Used for role boundary definitions: competent person (hazard recognition + authority to correct) and qualified person (credential/knowledge demonstration), which are not interchangeable labels in scaffold workflows. |
| OSHA 1926.454 scaffold training requirements | Apr 27, 2026 | Official U.S. regulation checked Apr 27, 2026. Used for user/erector training scope and retraining triggers when scaffold type changes, inadequacy is observed, or employee proficiency is not retained. |
| OSHA 1926.502(d) fall-arrest rescue and inspection duties | Apr 27, 2026 | Official U.S. regulation checked Apr 27, 2026. Used for fall-arrest operational boundaries: impact-loaded PFAS components must be removed until competent-person reuse determination (d)(19), prompt rescue/self-rescue coverage is mandatory (d)(20), and PFAS must be inspected before each use with defective components removed (d)(21). |
| OSHA 1926.452(w) mobile scaffold requirements | Apr 27, 2026 | Official U.S. regulation checked Apr 27, 2026. Used for mobile-scaffold movement boundaries: rider movement conditions (surface within 3 degrees level, movement ratio at 2:1 or tested equivalent, outrigger-frame symmetry, power speed <=1 ft/s), and movement awareness controls before repositioning. |
| OSHA eTool planking reference | Apr 27, 2026 | OSHA eTool page checked Apr 27, 2026. Used for light/medium/heavy plank loading references (25/50/75 psf), concentrated-load examples (250/500/750 lb), and span sensitivity context. |
| Safe Work Australia general guide for scaffolds | Apr 27, 2026 | Official Australian guide (July 2014 edition) checked Apr 27, 2026. Used for duty classes (225/450/675 kg per bay), concentrated-load references (120/150/200 kg), platform geometry limits, and >4 m high-risk licensing trigger. |
| Safe Work Australia guide to scaffold inspection and maintenance | Apr 27, 2026 | Official Australian guide (July 2014 edition) checked Apr 27, 2026. Used for written handover confirmation, >4 m scaffold inspection rhythm (at least every 30 days), and checklist controls including written approval before mixing components. |
| SafeWork NSW scaffolding obligations page | Apr 27, 2026 | Official NSW regulator page checked Apr 27, 2026. Used for NSW operational cadence (at least every 30 days + daily checks), powerline rule boundary (confirm safe working distance with the network provider), and immediate enforcement-cost signal (on-the-spot fines up to $900 for individuals and $4,500 for corporations). |
| SafeWork NSW scaffold management and inspection checklist | Apr 27, 2026 | Official NSW checklist PDF checked Apr 27, 2026. Used for NSW process controls: inspect before first use and at intervals not exceeding 30 days (plus after incidents/alterations), and keep handover-certificate minimum information available because tags alone typically do not contain the full minimum data. |
| SafeWork NSW scaffold handover certificate template | Apr 27, 2026 | Official NSW handover template checked Apr 27, 2026. Used for minimum information pack: scaffold duty loading, maximum number of working platforms, scaffold dimensions, intended use, relevant standard references, and declaration that scaffold is complete and safe for intended use. |
| SafeWork NSW electrical safety in construction checklist | Apr 27, 2026 | Official NSW checklist PDF checked Apr 27, 2026. Used for electrical trigger boundary: scaffold work or work from scaffolds should not be carried out within 4 m of overhead electric lines unless control measures and supply-authority requirements are satisfied. |
| Safe Work Australia scaffolding hazard topic | Apr 27, 2026 | Official Safe Work Australia scaffolding topic page checked Apr 27, 2026. Used for AU boundary triggers: high-risk construction work with fall risk >2 m requires SWMS, scaffolding work over 4 m requires high risk work licence coverage, and licence classes are split into basic/intermediate/advanced scaffolding. |
| Safe Work Australia model code: Managing the Risk of Falls at Workplaces | Apr 27, 2026 | Official model code PDF checked Apr 27, 2026. Used for AU control hierarchy (eliminate work at height first, then fall-prevention devices/work positioning/fall-arrest) and legal boundary that model codes guide compliance but only have legal effect when adopted in a jurisdiction. |
| HSE tower scaffold guidance | Apr 27, 2026 | Official UK HSE page checked Apr 27, 2026 (page updated 2026-03-10). Used for firm-level support, no-bricks warning, incompatible-components warning, max-4m before movement, overhead-line check before movement, and no-move-with-people/materials or windy-condition rule. |
| HSE scaffolding information (independent scaffolds) | Apr 27, 2026 | Official UK HSE guidance checked Apr 27, 2026. Used for design-route boundary (recognized standard configuration vs bespoke competent-person design), independent scaffold load classes (0.75 / 2.0 / 3.0 kN/m²), and default assumption that unspecified class is general-purpose 2.0 kN/m². |
| HSE scaffold FAQ | Apr 27, 2026 | Official UK HSE FAQ checked Apr 27, 2026. Used for documentation boundary: tag systems can supplement inspection practice, but they do not replace legal inspection/handover duties. |
| HSE CIS47 scaffold inspection and reports | Apr 27, 2026 | Official HSE construction information sheet checked Apr 27, 2026. Used for UK report particulars boundary: report records should capture site/equipment identification, inspection date-time, defects affecting safety, actions taken, and inspector identity. |
| UK Work at Height Regulations 2005, Regulation 12 | Apr 27, 2026 | Official UK legislation checked Apr 27, 2026. Used for mandatory inspection rhythm (within previous 7 days for construction platforms with potential 2m fall), report timing (end of working period + provide within 24 hours), transfer evidence when equipment leaves an undertaking, and report-retention duties (site until construction completion + office for 3 months). |
| UK Work at Height Regulations 2005 (Regulation 6 and 7) | Apr 27, 2026 | Official UK legislation PDF checked Apr 27, 2026. Used for planning hierarchy (avoid work at height where reasonably practicable, otherwise prevent falls, then minimize distance and consequences) and collective-protection priority over personal protection controls. |
| OSHA Top 10 cited standards (FY 2025) | Apr 27, 2026 | Official OSHA page checked Apr 27, 2026 (page updated 2026-04-15). Used as enforcement signal: for FY 2025 (Oct 1, 2024 to Sep 30, 2025), scaffolding standard 1926.451 is listed #6 in the federal Top 10 list. |
| OSHA 29 CFR 1903.15 civil penalty schedule | Apr 27, 2026 | Official U.S. regulation text checked Apr 27, 2026. Used for enforcement-cost baseline: for penalties proposed after January 15, 2025, serious/other-serious max is $16,550 per violation, and willful/repeat max is $165,514 per violation. |
| OSHA instance-by-instance citation policy memo (2024-04-17) | Apr 27, 2026 | Official OSHA memo checked Apr 27, 2026. Used for enforcement boundary: Appendix A includes scaffold platform-construction clause 1926.451(b)(1), allowing per-instance citation treatment when policy criteria are met. |
| OSHA NAICS 23 cited standards table (construction) | Apr 27, 2026 | Official OSHA cited-standards table checked Apr 27, 2026. Used for construction-specific enforcement intensity: 1926.451 shows 2,159 citations with $7,818,667 current penalties, and scaffold training standard 1926.454 shows 251 citations with $549,791 current penalties. |
| OMB M-26-11 penalty inflation adjustment cancellation (2026-04-17) | Apr 27, 2026 | Official OMB memo checked Apr 27, 2026. Used for penalty-update boundary: due missing October 2025 CPI-U data during the shutdown, agencies were directed to issue no 2026 inflation adjustment and continue using 2025 civil monetary penalty levels. |
| OSHA enforcement memos index | Apr 27, 2026 | Official OSHA memo index checked Apr 27, 2026. Used to confirm the latest OSHA-hosted annual civil-penalty adjustment memo listing remains dated 2025-01-07. |
| OSHA CPL 03-00-025 National Emphasis Program - Falls | Apr 27, 2026 | Official OSHA directive PDF checked Apr 27, 2026. Used for current U.S. enforcement posture: signed 2023-04-24 and effective 2023-05-01, with scope language stating all construction inspections related to falls are conducted under this NEP. |
| U.S. BLS Census of Fatal Occupational Injuries (2024, released 2026-02-19) | Apr 27, 2026 | Official U.S. BLS release checked Apr 27, 2026. Used for latest U.S. incident signal: total occupational fatalities decreased from 5,283 (2023) to 5,070 (2024), fatal falls/slips/trips decreased from 885 to 844, and construction/extraction occupations recorded 1,032 fatalities with fatal falls/slips/trips in that occupation group decreasing from 400 to 370. |
| U.S. BLS SOII Table 2 (2023-24 annualized, released 2026-01-22) | Apr 27, 2026 | Official U.S. BLS table checked Apr 27, 2026. Used for non-fatal workload signal: private-industry falls/slips/trips show 721,720 annualized DART cases and 479,480 annualized DAFW cases over 2023-24, with annualized incidence rates 34.1 (DART) and 22.6 (DAFW) per 10,000 full-time workers. |
| HSE work-related fatal injuries overview (Great Britain) | Apr 27, 2026 | Official HSE statistics page checked Apr 27, 2026. Used for latest risk context: 124 worker fatalities in 2024/25, with 35 caused by falls from height; HSE marks these figures provisional until July 2026. |
| HSE non-fatal injuries by accident type (Great Britain) | Apr 27, 2026 | Official HSE statistics page checked Apr 27, 2026. Used for UK non-fatal risk profile: falls from height account for 8% of reported non-fatal injuries to employees, with an annual rate of 209 per 100,000 workers over 2020/21 to 2024/25. |
| HSE construction statistics in Great Britain (2025 release) | Apr 27, 2026 | Official HSE PDF checked Apr 27, 2026 (published 2025-11-20). Used for sector-intensity signal: construction fatal injury rate is 1.92 per 100,000 workers (around 4.8 times all-industry), an estimated 50,000 construction workers each year suffer non-fatal injuries over 2022/23 to 2024/25, and falls from height account for 53% of construction worker fatalities (5-year average). |
| HSE Annual Report and Accounts 2024/25 | Apr 27, 2026 | Official UK HSE annual report PDF checked Apr 27, 2026 (financial year 2024/25). Used for enforcement-execution signal: 246 criminal prosecutions, 96% conviction rate, over GBP 33 million in fines, over 4,400 notices, and over 13,200 inspections. |
| Safe Work Australia key WHS statistics (latest release) | Apr 27, 2026 | Official Safe Work Australia statistics page checked Apr 27, 2026 (release date 2025-10-16). Used for latest national risk signal: 188 worker fatalities in 2024, including 24 fatalities from falls from height (13%). |
| Safe Work Australia key WHS statistics workbook (2025, serious-claims split) | Apr 27, 2026 | Official Safe Work Australia workbook checked Apr 27, 2026. Used for non-fatal burden signal in 2023-24p: 32,000 serious workers-compensation claims from falls/slips/trips, including 24.4% falls from height and 68.3% falls on the same level. |
| SafeWork NSW Annual Regulatory Statement 2024–25 | Apr 27, 2026 | Official NSW regulator statement checked Apr 27, 2026. Used for NSW 2024/25 enforcement direction and priority context: stronger penalties and more on-the-spot fines, targeted construction compliance including scaffold erection/use, and reported 17 construction fatalities from falls from height over 2018-2022. |
| PASMA FAQ on EN 1004 and BS 1139-6 tower standards | Apr 27, 2026 | Industry body page checked Apr 27, 2026. Used for standards-scope boundary: EN 1004-1:2020 applies up to 8 m outdoor and 12 m indoor towers; outside this scope PASMA points to BS 1139-6 route. |
| Werner stage 2512 product data | Apr 27, 2026 | Manufacturer product page checked Apr 27, 2026. Used as public market benchmark: 20 in width, 12 ft length, and 500 lb duty note for two-person stage use. |
| Werner stage 2632 product data | Apr 27, 2026 | Manufacturer product page checked Apr 27, 2026. Used as long-span benchmark: 24 in width, 32 ft length, and 500 lb duty note. |
| Metaltech 10 ft x 19 in all-aluminum platform (M-MPA1019) | Apr 27, 2026 | Official manufacturer product page checked Apr 27, 2026. Used as public dimension benchmark: 10 ft x 19 in with listed 75 lb/ft² capacity. |
| Metaltech two-person stage 12 in x 20 ft (M-SPA21220) | Apr 27, 2026 | Official manufacturer product page checked Apr 27, 2026. Used as public dimension benchmark: 12 in x 20 ft x 6 in with listed 500 lb capacity. |
Swipe horizontally to review clause-level thresholds and escalation triggers.
| Jurisdiction | Clause / source anchor | Threshold and condition | How to use in RFQ | Escalation trigger |
|---|---|---|---|---|
| US OSHA | 29 CFR 1926.451(a)(1) Source | Scaffold/component must support own weight + at least 4x max intended load. | Ask for load basis and support spacing evidence for the exact plank/deck SKU. | Supplier cannot demonstrate the load model behind the quote or assumptions conflict with site loading. |
| US OSHA | 29 CFR 1926.451(c)(1), (c)(1)(ii) Source | When supported scaffold height exceeds 4:1 of minimum base dimension, it must be restrained by guying/tying/bracing at the first point nearest 4:1 height, then at vertical intervals <=20 ft (width <=3 ft) or <=26 ft (width >3 ft), and at horizontal intervals <=30 ft. | Capture planned working height and base dimension during RFQ. If the setup will cross 4:1, request restraint layout and interval evidence before release. | Quote package has height/base data but no periodic restraint plan, or interval spacing is unspecified for multi-lift/tall setups. |
| US OSHA | 29 CFR 1926.451(b)(1)-(b)(5) Source | Most platforms/walkways >=18 in width, front edge <=14 in from work face, plank gaps <=1 in, support extension >=6 in, overhang cap 12 in (<=10 ft plank) / 18 in (>10 ft). | Convert dimensions to one unit set (mm or in) and screen before sending RFQ. | Width/edge/overhang cannot be shown inside limits or exception basis is unclear. |
| US OSHA | 29 CFR 1926.451(b)(6)-(b)(7) Source | Planks may abut only when each end rests on a separate support; where planks overlap, overlap must be at least 12 in unless movement is restrained. | Capture whether the setup is abutted or overlapped and request explicit support-point evidence in replacement and retrofit RFQs. | Supplier or site team cannot show support-point detail for abutted/overlapped planks. |
| US OSHA | 29 CFR 1926.451(b)(9) Source | Wood platforms must not be covered with opaque finishes, except edge coding and specified preservative/fire-retardant/slip-resistant treatments. | When timber planks are proposed as fallback, verify coating policy so inspections can still detect defects. | Timber plank proposal relies on full opaque coating with no defect-visibility controls in place. |
| US OSHA | 29 CFR 1926.451(b)(10)-(b)(11) Source | Components from different manufacturers must not be intermixed unless they fit without force and structural integrity is maintained; component modification to force intermixing requires competent-person determination and manufacturer approval; dissimilar metals must not be used together where galvanic action could reduce component strength below required limits. | Treat replacement purchases as compatibility workflows, not size-only transactions. Capture system-family fit and galvanic-compatibility evidence when aluminium decks interface with steel components. | RFQ relies on “same nominal dimensions” without manufacturer/system compatibility proof or galvanic-action assessment for mixed-metal interfaces. |
| US OSHA | 29 CFR 1926.451(f)(4), (f)(16) Source | Competent-person inspection before each shift and after events affecting integrity; platform deflection <=1/60 span. | Keep inspection readiness and deflection checks in handover notes, not only in safety briefings. | No inspection owner/logging plan or visible over-deflection risk for intended span/load. |
| US OSHA | 29 CFR 1926.451(f)(5) Source | Scaffolds must not be moved horizontally while employees are on them unless the scaffold is specifically designed by a registered professional engineer for that movement, or the structure is a mobile scaffold that meets 1926.452(w). | Treat occupied movement as an exception workflow that needs clause-level evidence, not as a default assumption in plank/platform RFQs. | Movement with workers onboard is planned but no engineer-design basis or 1926.452(w) condition evidence is attached. |
| US OSHA | 29 CFR 1926.451(f)(6), Exception Source | Energized-line clearances: <300V = 3 ft; 300V-50kV = 10 ft; >50kV = 10 ft + 0.4 in per 1 kV over 50kV. Closer work only after utility/operator de-energizes, relocates, or protects lines. | Treat overhead-line proximity as a hard release gate in RFQ workflow and capture utility-coordination evidence in writing. | No documented clearance or no utility/operator control plan where clearances cannot be met. |
| US OSHA | 29 CFR 1926.451(f)(13) Source | Work on/from scaffolds is prohibited during storms or high winds unless a competent person confirms safety and fall/wind protections are active. | Add weather contingency and stop-work logic to procurement and handover notes. | Planned use in strong-wind periods without a competent-person determination and control plan. |
| US OSHA | 29 CFR 1926.451(e)(1), (e)(9) Source | When scaffold platforms are more than 2 ft above or below a point of access, employers must provide safe access; cross braces must not be used as access. | Capture access method (ladder, stair tower, ramp, or equivalent) in RFQ and handover, not only plank dimensions. | Platform-height assumptions are present but no access-path owner or method is defined. |
| US OSHA | 29 CFR 1926.451(g)(1) Source | Each employee on a scaffold more than 10 ft above a lower level must be protected from falling to that lower level. | Treat platform height above 10 ft as a controlled gate that requires explicit fall-protection planning before release. | Request crosses the 10 ft threshold but no guardrail/fall-arrest planning evidence is attached. |
| US OSHA | 29 CFR 1926.502(d)(19)-(d)(21) Source | For personal fall-arrest systems: impact-loaded components are removed from service until competent-person reuse determination; employers must provide prompt rescue (or ensure self-rescue); and PFAS must be inspected before each use with defective components removed from service. | When PFAS is part of the >10 ft protection route, attach rescue workflow ownership and daily gear-inspection checks to procurement handover, not only harness availability statements. | Fall-arrest is claimed but there is no prompt-rescue/self-rescue plan, no pre-use inspection ownership, or no process for impact-loaded equipment removal. |
| US OSHA | 29 CFR 1926.451(f)(8) Source | Work on snow- or ice-covered scaffolds is prohibited except to remove snow/ice under competent-person direction. | Add weather-state checks for winter or cold-region schedules; deck selection does not override this stop-work boundary. | Planned use includes snow/ice conditions but no competent-person removal/control workflow is documented. |
| US OSHA | 29 CFR 1926.454(a)-(c) Source | Scaffold users and erectors must be trained by a qualified person, and retrained when scaffold type/site conditions change or inadequacy is observed. | Add training owner and retraining trigger checks to procurement handover before work starts. | No evidence of user/erector training coverage for changed setup, deck type, or revised site conditions. |
| US OSHA | 29 CFR 1926.450(b) + 29 CFR 1926.451(f)(7) Source | “Competent person” and “qualified person” are separately defined in OSHA (1926.450). 1926.451(f)(7) also requires scaffolds to be erected, moved, dismantled, or altered only under supervision and direction of a competent person qualified in those activities. | Set role ownership explicitly in RFQ handover: who has hazard-correction authority, who is responsible for training scope, and who supervises move/alteration activity. | Handover names only one generic role with no authority/training/supervision split for the actual scaffold activity. |
| US OSHA | 29 CFR 1926.452(w)(6), (w)(10) Source | Mobile scaffolds with employees onboard may be moved only when all movement conditions are met (surface within 3 degrees level, movement ratio at 2:1 unless equivalent stability is proven, no worker outside support lines, and powered speed <=1 ft/s); movement must account for dislodged materials and support clearances. | Treat occupied movement as a separate go/no-go check, not a generic extension of plank-size screening. | Any movement condition is unknown, the site path is not level/clear, or teams assume rider movement without clause-level confirmation. |
| Australia (Safe Work guide) | General guide, July 2014 edition Source | Duty classes per bay: 225/450/675 kg plus concentrated loads 120/150/200 kg; >4 m scaffold work marked as high-risk licensing scope. | Classify quote requests into public duty language before supplier shortlisting. | Request exceeds public heavy-duty band or licensing scope is uncertain for the job context. |
| Australia (Safe Work guide) | General guide geometry notes Source | Typical platform-width references 450/900/1000 mm by duty type; max plank gaps around 10 mm; overlap around 300 mm. | Use geometry checks early for replacement and mixed-stock jobs to avoid wrong-component purchase. | Deck geometry cannot be verified from current setup photos/manuals. |
| Australia (Safe Work inspection guide) | Guide to scaffold inspection and maintenance Source | Where a scaffold or suspended scaffold is >4 m, inspection is required before use and at least every 30 days; handover and alteration checks require written confirmation. | Add inspection-cadence owner and written handover evidence to RFQ acceptance criteria when AU workflows apply. | No inspection owner or no written confirmation process for handover/alteration controls. |
| Australia (Safe Work Australia topic page) | Scaffolding hazard topic (SWMS + licensing triggers) Source | High-risk construction work with fall risk >2 m requires SWMS; scaffolding work over 4 m requires high risk work licence coverage, with licence classes split into basic/intermediate/advanced scaffolding. | Add SWMS ownership plus licence-class fit checks before price-first RFQ release in AU workflows. | No SWMS owner for >2 m fall-risk activity, no documented >4 m licence coverage, or no mapping between job scope and licence class. |
| Australia (Safe Work model code) | Managing the Risk of Falls at Workplaces (model code) Source | Control hierarchy: eliminate work at height first, otherwise use fall-prevention devices/work positioning/fall-arrest in descending order of control strength. | Use hierarchy language in procurement decisions so route choice reflects risk-control strength, not only quote speed. | Route recommendation skips control hierarchy and relies on dimension-only compliance claims. |
| Australia (SafeWork NSW) | Scaffolding obligations page Source | SafeWork NSW states scaffolds should be inspected at least every 30 days and checked daily by users; when close to power lines, teams should confirm safe working distance with the network provider. | Keep NSW cadence and network-provider clearance confirmation as explicit go/no-go checks in mixed-market and AU tenders. | No documented daily-check routine, 30-day inspection plan, or utility-distance confirmation for overhead-line work. |
| Australia (SafeWork NSW) | Scaffold checklist + handover template Source | Inspect before first use, at intervals not exceeding 30 days, and after incidents/alterations; keep minimum handover information (duty loading, maximum working platforms, scaffold dimensions, intended use, and safe-use declaration). | Request the latest handover certificate and next inspection due date as part of commercial handover, not only on site. | Workflow relies on scaffold tag/photo only, without handover-certificate minimum fields or clear inspection due date. |
| Australia (SafeWork NSW) | Electrical safety checklist Source | Do not carry out scaffold work or work from scaffolds within 4 m of overhead electric lines unless control measures and supply-authority requirements are in place. | Use 4 m as a NSW pre-screen trigger, then document network-provider controls before RFQ release. | Planned setup or movement enters the 4 m envelope, or overhead distance is unknown with no supply-authority plan. |
| UK HSE scaffolding info | Independent scaffold duty classes and default Source | Typical classes are 0.75 kN/m² (very light), 2.0 kN/m² (general purpose), and 3.0 kN/m² (heavy duty); if no class is stated, assume general purpose (2.0 kN/m²). | Require explicit unit basis in UK-linked tenders so “heavy duty” claims are not compared against AU kg-per-bay labels without context. | Supplier response omits class/unit basis or mixes kN/m² and kg-per-bay claims without scaffold-bay geometry assumptions. |
| UK HSE scaffolding info | Recognized standard configuration vs bespoke design Source | Scaffolds should follow recognized standard configurations (for example TG20) or otherwise be covered by bespoke competent-person design documentation. | Capture whether the quote relies on a standard configuration or bespoke design route before commercial sign-off. | Route is non-standard but no competent-person design pack is attached (site, intended use, load class, lift count, tie pattern). |
| UK HSE tower guidance | Tower scaffolds page (updated 2026-03-10) Source | Firm, level support only; never use bricks/blocks; never use incompatible components; reduce to maximum 4 m before moving; check overhead lines before movement; never move with people/materials onboard or in windy conditions. | Attach movement and footing controls to route recommendation, even when purchase scope is only planks/platforms. | Site plan assumes movement outside these controls. |
| UK legislation | Work at Height Reg. 6 and 7 Source | Planning must avoid work at height where reasonably practicable, otherwise prevent falls, then minimize fall distance/consequences; collective protection is prioritized over personal protection. | Use these hierarchy checks when a route is technically feasible but relies too heavily on personal controls or undocumented assumptions. | Quote workflow selects a fast route without documenting why stronger collective controls were not reasonably practicable. |
| UK HSE (inspection report particulars) | CIS47 / WAHR report-content guidance Source | Inspection report records should include location/equipment identification, date and time, defects affecting safety, corrective actions taken, and inspector identity details. | Set inspection-report content requirements in procurement handover so hire/transfer workflows do not fail on missing particulars. | Inspection evidence exists but omits defect/action fields or cannot trace who completed and signed the inspection. |
| UK legislation | Work at Height Reg. 12(3)(b), 12(4), 12(5), 12(7), 12(8) Source | For construction platforms with potential fall >=2 m: inspect at suitable intervals and after exceptional circumstances likely to jeopardize safety, with a hard 7-day maximum interval; report by end of working period and supplied within 24 hours; equipment leaving/entering undertakings must carry last-inspection evidence; reports kept on site until work completion then at office for 3 months. | Treat inspection evidence transfer and retention as procurement dependencies when hire/transfer workflows are in scope. | No owner/process for inspection reporting, transfer evidence, or report retention in regulated UK workflows. |
Documentation pack
This table turns checklist language into release-ready actions. Use it when the quote looks technically feasible but supporting documents are incomplete.
Swipe horizontally to compare minimum documentation packs and failure patterns.
| Workflow lane | Minimum document pack | Common failure pattern | Release action | Source |
|---|---|---|---|---|
| NSW scaffold handover baseline | Handover certificate fields: duty loading, maximum working platforms, scaffold dimensions, intended use, and safe-use declaration. | Tag photo exists but no certificate fields are attached in procurement thread. | Request handover-certificate minimum fields and next inspection due date before RFQ release. | SafeWork NSW scaffold handover certificate template |
| NSW inspection-cycle control | Inspection before first use, then intervals not exceeding 30 days, and after incidents/alterations. | Project team cannot show timing owner or most recent inspection date. | Treat as controlled/manual route until inspection cadence ownership is documented. | SafeWork NSW scaffold management and inspection checklist |
| UK report particulars | Inspection report should record location/equipment identification, date-time, safety defects, actions taken, and inspector identity. | Report says “inspected” but lacks defect/action particulars or signatory details. | Hold release and ask for a complete report record that supports audit/transfer checks. | HSE CIS47 scaffold inspection and reports |
| UK design-route evidence | State whether scaffold is a recognized standard configuration or bespoke competent-person design route. | Quote is non-standard but no design pack (load class, lift count, tie pattern, intended use) is attached. | Escalate to manual review before quote confirmation. | HSE scaffolding information (independent scaffolds) |
| Tag system boundary (UK/NSW) | Tag systems can supplement workflow, but legal handover/inspection evidence must still be complete. | Team treats tag color/status as full substitute for documentation pack. | Require tag + report/certificate pairing in the same handover packet. | HSE scaffold FAQ |
Dimension layer
This section separates public dimension baselines from conditions that still require manual confirmation. Use it to avoid “dimension-only” RFQs that skip support, compatibility, or jurisdiction-specific controls.
Swipe horizontally to compare dimension questions, public baselines, and limitation notes.
| Decision question | What public sources confirm | Boundary / limitation | Source |
|---|---|---|---|
| What baseline applies when buyers ask for “aluminium scaffold plank dimensions”? | OSHA baseline is generally >=18 in platform width, with narrower exceptions (such as ladder-jack and bracket setups) down to 12 in in defined conditions. | Exception widths are not default procurement targets; document why the exception applies and what compensating controls are active. | OSHA 1926.451 general scaffold requirements |
| Can planks be overlapped or abutted interchangeably? | OSHA separates the two conditions: abutted plank ends must sit on separate supports; overlapped planks require >=12 in overlap unless movement is restrained. | Dimension-only requests miss support-point geometry; missing support evidence should move the case to controlled/manual review. | OSHA 1926.451 general scaffold requirements |
| Which AU geometry numbers are publicly available for first-pass checks? | Safe Work Australia guide provides public screening references including 450/900/1000 mm platform-width bands, around 10 mm plank-gap limit, and around 300 mm overlap context. | These are public guide-level figures (2014 edition), not a substitute for current product manuals and jurisdiction-specific project controls. | Safe Work Australia general guide for scaffolds |
| Can UK load classes and AU duty classes be mapped directly in one spreadsheet? | UK HSE independent scaffold guidance uses load classes by area (0.75 / 2.0 / 3.0 kN/m², default 2.0 kN/m² if unspecified), while AU guidance publishes 225/450/675 kg per bay classes. | These units are not one-to-one equivalents. Direct conversion is unreliable without bay geometry and layout assumptions, so mixed-market RFQs need explicit unit basis. | HSE scaffolding information (independent scaffolds) |
| What inspection cadence should be budgeted for AU workflows? | Safe Work Australia inspection guide and SafeWork NSW both publish at-least-every-30-days inspection expectations for relevant scaffolds; SafeWork NSW also states users should check scaffolds daily. | Head-contract, site, and state requirements may be stricter, so workflow ownership and written records still need manual confirmation. | SafeWork NSW scaffolding obligations page |
| Can one overhead-line clearance distance be reused across US and AU jobs? | OSHA provides voltage-based clearances, while SafeWork NSW provides a 4 m overhead-line trigger in construction checklist controls and still requires supply-authority confirmation of safe working distances. | No universal AU-wide public matrix exists (待确认 per job). Treat electrical clearances as state- and network-specific release gates. | SafeWork NSW electrical safety in construction checklist |
| What minimum handover-certificate fields should NSW workflows capture before release? | SafeWork NSW template includes duty loading, maximum number of working platforms, scaffold dimensions, intended use, relevant standard references, and sign-off that scaffold is complete and safe for intended use. | Template fields are baseline only. Project-specific hazards, non-standard configurations, and transfer workflows still require additional manual confirmation. | SafeWork NSW scaffold handover certificate template |
| Can workers stay on a mobile scaffold while it is being moved? | OSHA 1926.452(w)(6) allows movement with workers onboard only when strict controls are met (3-degree level surface, movement stability ratio, and low powered speed conditions). | This is not a universal rule across jurisdictions. If any condition is unclear, default to unoccupied movement and manual boundary confirmation. | OSHA 1926.452(w) mobile scaffold requirements |
| If nominal dimensions match, can aluminium decks be mixed with steel components by default? | No. OSHA 1926.451(b)(11) restricts dissimilar-metal combinations where galvanic action could reduce strength below required limits. | Public clauses set the boundary but do not provide SKU-pair compatibility matrices. Treat mixed-metal replacement as 待确认 until supplier/manual evidence is complete. | OSHA 1926.451 general scaffold requirements |
| If dimensions pass, can I skip platform-height access and fall controls? | No. OSHA still requires safe scaffold access when platform level is >2 ft above/below access point and fall protection when workers are >10 ft above a lower level; scaffold-user training and retraining duties also apply. | Dimension compliance alone does not prove operational readiness. Height basis, access path, and training ownership remain mandatory release checks. | OSHA 1926.454 scaffold training requirements |
| Can one generic “competent person” label cover supervision, hazard correction, and training ownership? | OSHA 1926.450 defines competent and qualified persons separately, and 1926.451(f)(7) ties erection/movement/alteration work to competent-person supervision qualified in those activities. | Role title alone is insufficient. RFQ release still needs explicit authority split (hazard correction, supervision scope, and training ownership) in project records. | OSHA 1926.450 scaffold definitions |
| If timber planks are used as fallback, can they be fully painted before use? | OSHA 1926.451(b)(9) generally prohibits opaque finishes on wood platforms except edge coding and specified treatment categories. | Opaque coating can hide defects. If timber fallback is proposed, defect visibility and condition checks must be evidenced before release. | OSHA 1926.451 general scaffold requirements |
Swipe horizontally to review boundary exceptions and minimum actions before issuing RFQ.
| Baseline assumption | Counter-example / boundary condition | Why this matters commercially | Minimum action before release | Source |
|---|---|---|---|---|
| OSHA baseline: platforms/walkways are generally at least 18 in (457 mm) wide. | 29 CFR 1926.451(b)(2) allows narrower widths only when the work area itself prevents 18 in, and then additional fall-protection controls are required. | A narrow platform claim is not automatically acceptable. Procurement teams need documented reason plus compensating controls. | Record why 18 in is infeasible and require supplier/site confirmation of guardrail or personal fall-arrest setup. | OSHA 1926.451 general scaffold requirements |
| Buyers often assume plank overlap details are secondary if nominal length is known. | 29 CFR 1926.451(b)(6)-(b)(7) separates abutted and overlapped conditions: abutted ends must rest on separate supports; overlaps need at least 12 in unless restrained. | Dimension-only RFQs can miss support-point geometry, causing late rework or rejected setup. | Ask for a simple support-point sketch/photo and state whether the job uses abutted or overlapped plank configuration. | OSHA 1926.451 general scaffold requirements |
| OSHA baseline: platform gaps should not exceed 1 in (25 mm). | 29 CFR 1926.451(b)(1)(ii) allows up to 9.5 in around uprights when necessary and only if the platform remains as full as possible. | Local gaps around uprights can be valid exceptions, but continuous wide gaps remain a clear red flag. | Differentiate isolated upright clearances from continuous deck gaps in photos, inspection notes, and RFQ clarification. | OSHA 1926.451 general scaffold requirements |
| Replacement orders are often treated as “same dimensions = safe to intermix.” | 29 CFR 1926.451(b)(10)-(b)(11) blocks intermixing or forced modification unless fit/integrity and manufacturer approval conditions are satisfied, and also restricts dissimilar-metal combinations where galvanic action could reduce strength below required limits. | Nominal dimensions alone do not prove compatibility, especially for mixed-brand or mixed-metal fleets. | Require system family, model references, compatibility confirmation, and galvanic-action assessment before releasing replacement-only RFQs. | OSHA 1926.451 general scaffold requirements |
| Supported scaffolds may stand without extra ties only within height-to-base limits. | 29 CFR 1926.451(c)(1) requires tipping restraint when scaffold height exceeds a 4:1 ratio to the minimum base dimension. | Board or deck purchase decisions can fail at site acceptance if height/base geometry is omitted from procurement checks. | Capture planned platform height and minimum base dimension before quote release, then confirm tie/guy/bracing plan where needed. | OSHA 1926.451 general scaffold requirements |
| OSHA baseline: maintain minimum energized-line clearances before scaffold work. | The exception in 29 CFR 1926.451(f)(6) permits closer work only after utility/operator action (de-energize, relocate, or protective coverings). | “Near lines but careful” is not a valid release basis. Without utility controls, quote-ready status is unreliable. | Log voltage/clearance assumptions and obtain utility/operator control confirmation before approving a near-line route. | OSHA 1926.451 general scaffold requirements |
| Teams sometimes copy OSHA energized-line distances directly into all AU workflows. | SafeWork NSW directs teams to confirm safe working distance with the network provider when scaffolds are near power lines. | Using one imported distance rule can create compliance drift in state-regulated Australian projects. | In AU jobs, log the network-provider clearance advice instead of assuming OSHA numbers are automatically valid. | SafeWork NSW scaffolding obligations page |
| Teams often treat mobile-scaffold movement as one universal “no riders” or “riders allowed” rule. | OSHA 1926.452(w)(6) allows movement with riders only under strict conditions (3-degree level surface, 2:1 movement ratio or equivalent, and low-speed controls). UK HSE tower guidance applies a stricter “do not move with people onboard” baseline. | Cross-jurisdiction procurement can fail if movement assumptions are copied without mapping to the governing rulebook. | State movement policy by jurisdiction in the RFQ and default to unoccupied movement whenever occupied-movement conditions are not fully evidenced. | OSHA 1926.452(w) mobile scaffold requirements |
| Teams often assume that naming “fall arrest” in a quote is enough once platform height is above 10 ft. | OSHA 1926.502(d)(19)-(d)(21) still requires prompt rescue or self-rescue capability, pre-use PFAS inspection, and impact-loaded component removal until competent-person reuse determination. | Harness availability without rescue and inspection controls can still fail compliance and can increase post-incident severity/cost. | Add rescue workflow ownership, pre-use inspection cadence, and impact-loaded gear quarantine/review steps to the same handover packet as fall-protection claims. | OSHA 1926.502(d) fall-arrest rescue and inspection duties |
| If a scaffold tag is visible, teams sometimes assume documentation is complete. | SafeWork NSW checklist notes that tags generally do not contain the minimum information required in a scaffold handover certificate. | Tag-only evidence can pass visual checks but still fail audit and transfer requirements. | Attach the latest handover certificate (minimum fields + inspection timing) alongside any tag photo before route release. | SafeWork NSW scaffold management and inspection checklist |
| “Heavy duty” wording in UK and AU tenders is often treated as equivalent. | HSE independent scaffolds use kN/m² classes (0.75 / 2.0 / 3.0, default 2.0 when unspecified), while AU guidance uses kg-per-bay classes. | Unit mismatch can cause under-spec or over-spec purchases even when both quotes say “heavy duty”. | Force suppliers to state unit basis and scaffold geometry assumptions before accepting class comparisons. | HSE scaffolding information (independent scaffolds) |
| Timber plank fallback may be coated like a normal finished product. | OSHA 1926.451(b)(9) generally prohibits opaque finishes on wood platforms, except edge coding and specified treatment categories. | Opaque coating can conceal defects and weaken inspection reliability. | If timber fallback remains in scope, require visible-condition evidence and coating declaration before release. | OSHA 1926.451 general scaffold requirements |
| UK mobile-tower projects often default to EN 1004 language in procurement. | PASMA’s standards FAQ states EN 1004-1:2020 scope is up to 8 m outdoor and 12 m indoor; out-of-scope structures route to BS 1139-6. | Using EN 1004 terms without confirming height/scope can misclassify the job and create late compliance friction. | Capture indoor/outdoor operating height and standards route before RFQ; escalate to manual review when scope is unclear. | PASMA FAQ on EN 1004 and BS 1139-6 tower standards |
Swipe horizontally to inspect model-level dimension examples and procurement implications.
| Public model example | Listed dimensions | Listed capacity | How this changes RFQ behavior | Source |
|---|---|---|---|---|

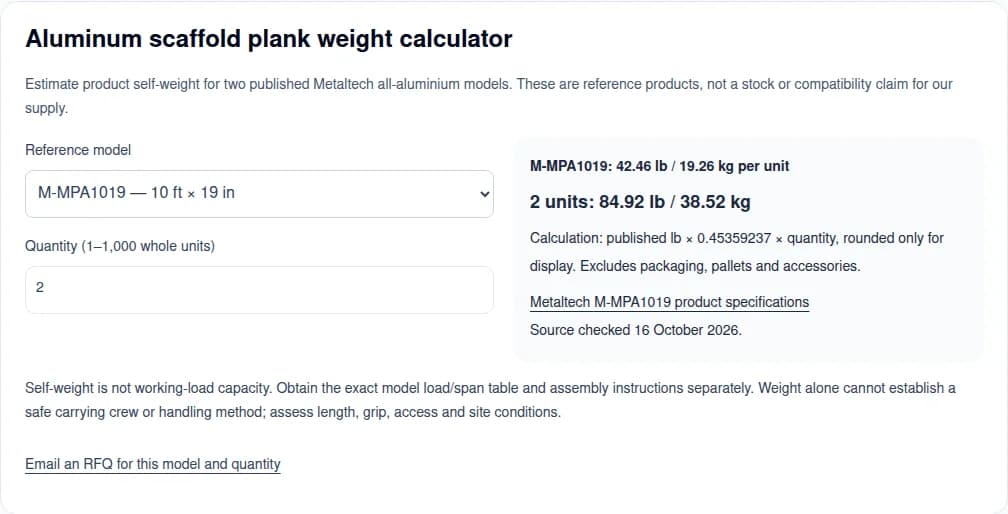

| Metaltech M-MPA1019 (all-aluminum platform) | 10 ft x 19 in | 75 lb/ft² | Shows that common aluminium platform products can be wide enough for OSHA baseline checks while using area-based capacity language. | Metaltech 10 ft x 19 in all-aluminum platform (M-MPA1019) |
| Metaltech M-SPA21220 (two-person stage) | 12 in x 20 ft x 6 in | 500 lb | Shows narrow-width long-span stage geometry that is materially different from platform modules and needs explicit scope matching. | Metaltech two-person stage 12 in x 20 ft (M-SPA21220) |
| Werner 2512 stage | 12 ft x 20 in | 500 lb | Useful midpoint benchmark for RFQ comparison against shorter/wider platform offerings. | Werner stage 2512 product data |
| Werner 2632 stage | 32 ft x 24 in | 500 lb | Shows that “aluminium scaffold plank dimensions” can vary substantially by system intent and should not be normalized into one default size. | Werner stage 2632 product data |
Comparison layer
Use this table to decide whether the request should stay in alloy/ aluminium plank quoting, move to controlled review, or escalate to manual review.
Swipe horizontally to compare all route columns on mobile.
| Route | Best for | Caution | Evidence lane | RFQ line |
|---|---|---|---|---|
| Alloy / aluminium plank RFQ route | Buyer has numeric load + width + span and needs practical supplier response fast. | Still requires explicit load-model and geometry evidence; “500 lb duty” marketing lines are not enough alone. | OSHA 4x capacity model + Safe Work duty bands + SKU-level manufacturer evidence. | “Confirm this plank/platform SKU supports X kg per bay at Y span with Z mm clear width under [market] requirements.” |
| Dimension-only request (insufficient) | Early triage when the buyer only has length/width wording and no validated load/support context yet. | High false-confidence risk: dimensions alone do not prove compliance, compatibility, or safe release. | Public clause checks (width/gap/overlap/intermixing) plus site and system evidence before quote status can advance. | “Before pricing, confirm load per bay, support spacing, overlap/abut condition, and compatibility for the exact model.” |
| Aluminium platform deck route | Trapdoor/platform module selection linked to full tower package compatibility. | Deck module fit can fail even when nominal width/load looks acceptable. | Manufacturer manual and system compatibility data plus public footing/movement rules. | “Confirm deck module compatibility with current frame system and approved support spacing.” |
| Timber plank fallback route | Retrofit situations where timber planks are already in scope and inspection team needs span/load checks. | Span limits tighten quickly under medium/heavy duty. Deflection and grade evidence are mandatory. | OSHA eTool span/load and 1/60 deflection references for screening only. | “State plank grade and allowable span at target duty; provide replacement rationale versus alloy route.” |
| Controlled review route | Inputs partially known but one boundary is weak (width, uneven support, replacement evidence). | Skipping evidence at this stage often causes quote revisions and procurement delays. | Public threshold data plus photo/drawing confirmation from site or existing stock. | “We can proceed if you confirm these missing compatibility and support details.” |
| Manual engineering route | High load, unstable support, unclear system, or standards-sensitive project documentation. | A simple price-first quote is likely misleading and operationally risky. | Current manual, competent-person review, project-specific structural checks, and jurisdiction-specific inspection plan. | “Hold quotation release until engineering/compliance review signs off on load/support assumptions.” |
Swipe horizontally to evaluate speed-vs-risk tradeoffs before committing to a route.
| Decision route | Speed benefit | Risk if evidence is skipped | Minimum evidence set | When to choose |
|---|---|---|---|---|
| Fast RFQ release | Lowest cycle time; supplier response starts quickly. | High re-quote risk if load model, geometry, or compatibility assumptions were implicit. | Load per bay, clear width, support span, standards scope, deck type intent, movement intent, and inspection owner/log cadence. | Only when all boundary inputs are explicit and no controlled/manual trigger is active. |
| Controlled RFQ | Moderate speed; keeps commercial process moving with safeguards. | If controls are removed, replacement/compatibility failures and site delays are common. | Everything in fast RFQ + photos/drawings + system identifiers + explicit role ownership split (supervision/training/inspection) + missing-assumption list. | Use when one or more boundary items are uncertain but solvable without full engineering sign-off. |
| Manual review before quote | Slower initial response but fewer late-stage reversals. | Potentially unsafe recommendation and high contractual/compliance exposure. | Current manuals, competent-person input, footing/support assessment, movement exception basis, and inspection ownership/log plan. | Use for >675 kg requests, unstable support, unclear compatibility, or regulated documentation workflows. |
| Replacement-only purchase | Can be quick if exact interchangeability is proven. | Wrong-component ordering, return cost, and installation delays. | Existing tower family, part references, deck interface details, current supplier compatibility statement. | Use only when replacement intent is confirmed and interface evidence is complete. |
Risk layer
This section makes boundaries explicit so teams do not mistake a route recommendation for final engineering approval.
| Risk | Trigger | Impact | Mitigation |
|---|---|---|---|
| Under-width platform setup | Clear width below public threshold for the standards scope in use. | Inspection rejection, delayed mobilization, and rework in procurement or setup stage. | Screen width early and keep stricter threshold visible for mixed-market jobs. |
| Unsupported or unstable base condition | Soft edge/void condition, or improvised support under base points. | Stability failure risk and invalid movement/setup assumptions. | Escalate to manual review; verify firm, level, properly supported footing before deck decisions. |
| Span mismatch against duty class | Long support span combined with medium/heavy duty in timber baseline scenarios. | Excess deflection risk or non-compliant plank performance under load and point-load stress. | Use controlled review and request SKU-level allowable span/load evidence. |
| Abut/overlap geometry not documented | RFQ includes plank dimensions but does not state whether planks are abutted or overlapped at supports. | Late discovery of non-compliant support geometry, causing setup rejection or expensive rework. | Capture support-point details and overlap/abut condition before quote release. |
| Energized-line proximity without a clearance plan | Overhead-line distance not confirmed against OSHA voltage-based clearances, or utility controls not documented. | Potential contact hazard and immediate escalation to manual/compliance review. | Capture voltage/clearance assumptions and utility/operator controls before any quote release. |
| Cross-jurisdiction electrical-clearance misuse | OSHA distance values are copied into AU workflows without network-provider confirmation. | Potential legal and safety non-conformance in state-regulated projects. | For AU jobs, treat network-provider clearance advice as mandatory evidence instead of importing a single global value. |
| Replacement compatibility drift | Replacement purchase without confirmed tower-system and deck-interface data. | Wrong component ordering, installation delay, return-cost exposure, or unsafe mixed-component use. | Collect frame/system identifiers, photos, and current manual references before PO. |
| Mixed-metal galvanic boundary miss | Aluminium deck components are paired with dissimilar metals without clause-level compatibility assessment. | Potential strength degradation over time and non-compliant mixed-component configuration. | Apply OSHA 1926.451(b)(11) boundary checks and require manufacturer/competent-person evidence for mixed-metal interfaces before release. |
| Movement-rule blind spot | Tower moved with people/materials onboard or without reducing height for movement. | Operational safety breach and potentially invalidated use assumptions. | Keep HSE no-rider movement baseline and OSHA 1926.452(w)(6) occupied-movement conditions in handover notes; default to unoccupied movement where conditions are uncertain. |
| Cross-jurisdiction movement-policy mismatch | A global RFQ template assumes one movement rule without mapping US OSHA vs UK HSE controls. | Route recommendation can be “compliant” in one market while failing another, creating avoidable rework and compliance delay. | Explicitly state movement policy by governing jurisdiction and capture evidence for any occupied-movement exception before release. |
| Inspection-record gap | No owner or timeline for shift checks / 7-day checks / report issue requirements in regulated workflows. | Compliance failure risk, stop-work exposure, and delayed handover. | Assign inspection ownership up front and capture report timing obligations in project workflow. |
| Fall-arrest route without rescue readiness | Team claims PFAS coverage above 10 ft but cannot show prompt rescue/self-rescue workflow, pre-use inspection ownership, or impact-loaded equipment quarantine process. | Residual high-severity fall consequence risk and likely compliance failure despite “harness provided” statements. | Apply OSHA 1926.502(d)(19)-(d)(21): document rescue owner, inspect PFAS before each use, and remove impact-loaded components until competent-person reuse determination. |
| Role-boundary ambiguity (competent vs qualified) | Handover assigns a generic “competent person” label but does not specify supervision scope, hazard-correction authority, and training ownership separately. | False-confidence risk in release decisions, with avoidable compliance and retraining failures during setup or alteration. | Map role responsibilities explicitly in RFQ and handover notes using OSHA 1926.450/1926.451(f)(7) role boundaries. |
| Transfer-evidence and retention breakdown | Hire/transfer flow lacks last-inspection evidence or there is no plan to retain reports until completion + 3 months. | Audit failure risk and contractual friction when equipment moves across undertakings. | Treat Reg.12 transfer evidence and retention duties as go/no-go checks in procurement handover. |
| Signal | Status | Why |
|---|---|---|
| Public duty class thresholds (225/450/675 kg) | Known now | Published in Safe Work Australia guidance and usable for first-pass load screening. |
| Minimum platform width baseline by market scope | Known now | Public OSHA and Safe Work thresholds provide usable numeric screening for this page. |
| OSHA energized-line clearance thresholds by voltage | Known now | Public OSHA clauses define concrete distance baselines (3 ft / 10 ft / +0.4 in-per-kV over 50 kV) and the utility-control exception path. |
| Height-triggered access and fall-protection boundaries | Known now | OSHA publicly defines access trigger (>2 ft) and fall-protection trigger (>10 ft) for scaffold workflows, so these can be used as release gates in this page. |
| AU trigger values for SWMS and >4 m high risk licence | Known now | Safe Work Australia publicly states SWMS trigger (>2 m fall-risk work) and licensing trigger (>4 m scaffolding work), so these can be used in first-pass route decisions. |
| NSW handover-certificate minimum information fields | Known now | SafeWork NSW checklist and handover template both provide public minimum-field expectations (duty loading, working-platform count, dimensions, intended use, and safe-use declaration). |
| Whether scaffold tags alone satisfy UK/NSW documentation duty | Known now | Public HSE FAQ and SafeWork NSW checklist both indicate tag systems are supplementary and should not be treated as full legal handover/inspection evidence. |
| Which AU scaffolding licence class (basic/intermediate/advanced) matches this scope | Needs manual confirmation | Public sources describe class categories, but project scope-to-class mapping still needs contractor/regulator confirmation for the exact setup. |
| Exact allowable span/load for chosen SKU in project setup | Needs manual confirmation | Public references do not replace product-manual limits for the specific deck and support condition. |
| Interchangeability for replacement-only orders | Needs manual confirmation | Replacement compatibility requires tower-family and component-interface evidence. |
| Mixed-metal (aluminium-steel) galvanic compatibility per SKU pair | Needs manual confirmation | OSHA provides a dissimilar-metal boundary, but project-level evidence still requires supplier/manual confirmation for the exact interface. |
| Open public clause text for AS/NZS scaffold standards | No reliable public data | State regulator pages reference AS/NZS 1576 and related standards, but full clause-level text is generally paywalled (暂无可靠公开数据 for free public clause extraction). |
| Direct conversion table between UK kN/m² classes and AU kg-per-bay classes | No reliable public data | Public sources publish each system in different unit models, but no authoritative crosswalk table is openly maintained (暂无可靠公开数据). |
| Cross-brand interchangeability matrix for alloy/aluminium planks | No reliable public data | HSE warns against incompatible components, but no normalized public compatibility matrix exists (暂无可靠公开数据). Use current supplier documentation and site evidence instead. |
| Global transaction price benchmark by duty class and span | No reliable public data | Public pages provide examples, not normalized transaction datasets (暂无可靠公开数据). Treat price as supplier- and project-specific. |
| Universal AU energized-line clearance number | No reliable public data | SafeWork NSW requires network-provider distance confirmation for nearby power lines; one universal public AU number is not provided (暂无可靠公开数据). |
| Universal AU rider-movement clause for all mobile scaffold types | No reliable public data | Public regulator pages provide movement-safety obligations, but one normalized AU-wide rider-movement matrix is not openly consolidated (暂无可靠公开数据). Confirm by state regulator + manufacturer documentation. |
| Site-specific footing adequacy at edges/voids | Needs manual confirmation | Public guidance requires competent assessment of supporting structure capacity. |
| Whether this specific request has a valid access-path and training owner | Needs manual confirmation | Regulatory triggers are public, but owner assignment and field execution evidence are project-specific and must be confirmed in handover. |
| Site-specific post-fall rescue time and retrieval path viability | Needs manual confirmation | OSHA rescue duty is public, but retrieval method, response timing, and constraints vary by site layout and access conditions. |
| Public scaffold-specific prosecution count for NSW 2024/25 | No reliable public data | SafeWork NSW annual statement provides priority and fatality context but does not publish a normalized scaffold-only prosecution total in the same document (暂无可靠公开数据). |
| 2026 federal penalty inflation adjustment status | Known now | OMB memo M-26-11 (2026-04-17) publicly states agencies should not issue a 2026 adjustment and should continue using 2025 penalty levels. |
Scenario examples
FAQ
Conversion layer
If your result is RFQ-ready, send the draft now. If controlled or manual, keep the evidence request explicit so suppliers can respond with usable boundaries instead of generic price-only answers.
Primary action
Use the generated draft from the tool and include all input numbers in the first email.
Secondary action
Compare broader product routes in the directory if the deck type is still uncertain.
Aluminium Scaffold Tower | Updated Apr 27, 2026
